Brent Charlie C1-46 Carbon Steel & Super Duplex

North Sea, Brent CharlieC1-46 & C1-24 Chopsaw180m

99.05%

Success Rate

47 min

Avg Cut Time

15

Cuts/Blade

Project Overview

Decom Engineering played a pivotal role in Shell's decommissioning at the Brent Field. The C1-46, developed and deployed in under 6 months, completed 79 cuts on its first deployment with a 99.05% success rate. Average cut times of 47 minutes (some as quick as 20 minutes) and 15 cuts per blade. Innovative clamp modifications reduced seabed dredging time from 3.5 hours to just 30 minutes.

Key Highlights

  • C1-46 developed and deployed in under 6 months
  • 79 cuts on first deployment with 99.05% success rate
  • Clamp modifications cut dredging from 3.5 hrs to 30 min

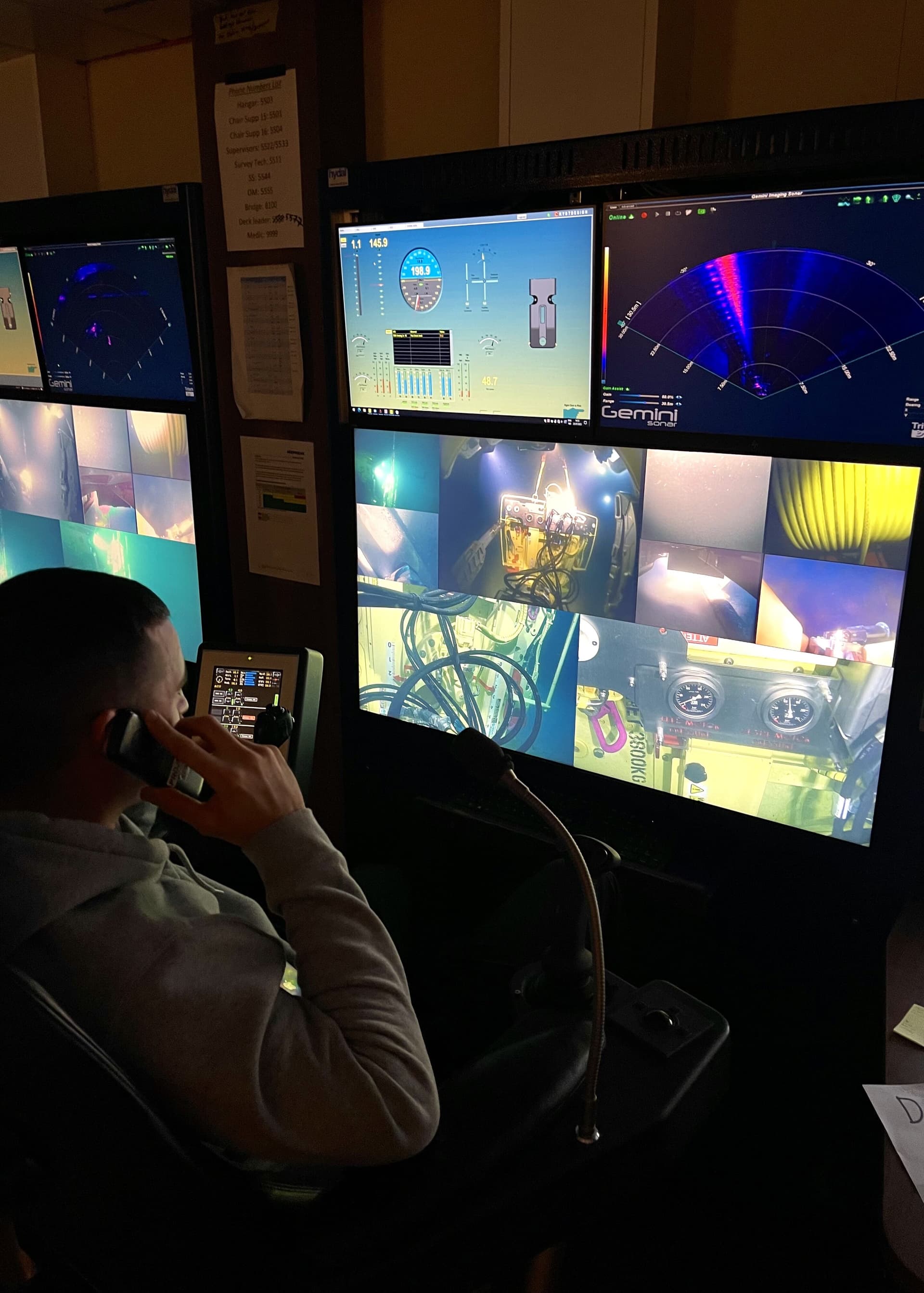

Project Gallery

Brent Charlie C1-46 Carbon Steel & Super Duplex - image 1
Brent Charlie C1-46 Carbon Steel & Super Duplex - image 2
Brent Charlie C1-46 Carbon Steel & Super Duplex - image 3
Brent Charlie C1-46 Carbon Steel & Super Duplex - image 4
Brent Charlie C1-46 Carbon Steel & Super Duplex - image 5
Brent Charlie C1-46 Carbon Steel & Super Duplex - image 6
